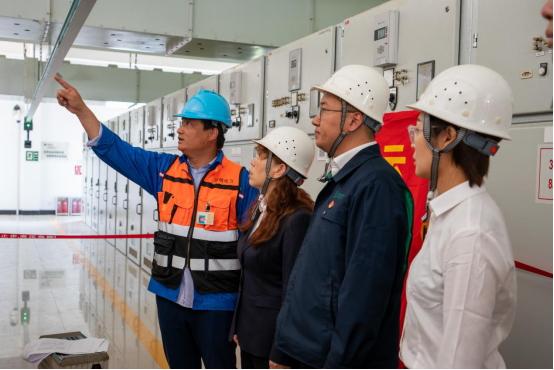

5月28日,青島地鐵8號線“雙接頭”分線箱順利完成送電,為地鐵1號線供電提供保障,也為8號線電流接入創造了條件。
地鐵8號線“雙接頭”分線箱(xiang)是1號線勝利橋(qiao)站(zhan)(zhan)開閉(bi)(bi)所、8號線閆(yan)家山(shan)站(zhan)(zhan)開閉(bi)(bi)所供電(dian)(dian)共(gong)接工(gong)(gong)程,由浩越(青島(dao))建(jian)設電(dian)(dian)力工(gong)(gong)程有限(xian)公司具體(ti)實施(shi),該工(gong)(gong)程屬于35千伏高(gao)壓施(shi)工(gong)(gong)項目,從(cong)國家電(dian)(dian)網虎山(shan)變(bian)電(dian)(dian)站(zhan)(zhan)引出(chu)一路高(gao)壓電(dian)(dian)源到(dao)分線箱(xiang),從(cong)分線箱(xiang)輸出(chu)兩路電(dian)(dian)源。一路為地鐵1號線勝利橋(qiao)站(zhan)(zhan)開閉(bi)(bi)所及周(zhou)邊7站(zhan)(zhan)8區間(jian)約(yue)(yue)11公里的范圍供電(dian)(dian);一路為地鐵8號線閆(yan)家山(shan)站(zhan)(zhan)開閉(bi)(bi)所南昌(chang)路北站(zhan)(zhan)至(zhi)紅島(dao)科技館站(zhan)(zhan)6站(zhan)(zhan)5區間(jian)約(yue)(yue)17公里的范圍供電(dian)(dian)。主要工(gong)(gong)作為新建(jian)分線箱(xiang)1座(zuo)、敷設高(gao)壓電(dian)(dian)纜(lan)(lan)約(yue)(yue)420米和電(dian)(dian)纜(lan)(lan)設備的試驗調試,以及外(wai)部相(xiang)應(ying)的配套(tao)工(gong)(gong)作。

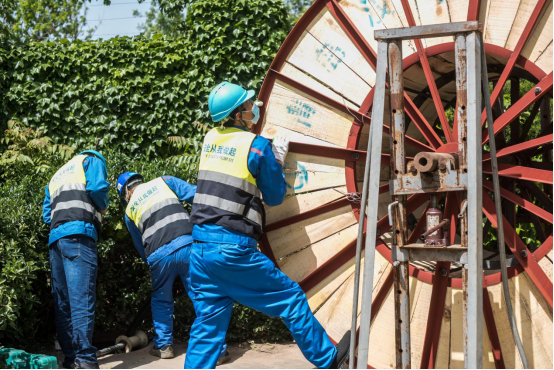

本工程采用的電(dian)(dian)纜(lan)為目前青島地鐵(tie)最高(gao)(gao)規格的單(dan)芯(xin)高(gao)(gao)電(dian)(dian)壓(ya)電(dian)(dian)纜(lan),其直徑達(da)(da)到(dao)7厘(li)米(mi),總重量達(da)(da)6.5噸,需(xu)要(yao)將3根單(dan)芯(xin)電(dian)(dian)纜(lan)擺成“品”字(zi)形敷設至2米(mi)高(gao)(gao)的管廊支架(jia)上(shang)固定,受管廊空間限制(高(gao)(gao)2.2米(mi),寬2米(mi))無法使用機(ji)械,只能靠有限的人力將沉(chen)重的電(dian)(dian)纜(lan)抬放到(dao)支架(jia)上(shang),且(qie)管廊支架(jia)上(shang)還有已經通電(dian)(dian)的多條高(gao)(gao)壓(ya)電(dian)(dian)纜(lan),施工危(wei)險(xian)系數高(gao)(gao),難度大。
“起跑(pao)即沖(chong)刺、開(kai)局(ju)即決戰”八號(hao)線(xian)(xian)公司迎難而上絕不(bu)退縮,為滿足1號(hao)線(xian)(xian)勝(sheng)利橋開(kai)站閉(bi)所(suo)5月(yue)底外部電源引入的工(gong)期需求,從3月(yue)份開(kai)始(shi)著手(shou)準備,僅在短(duan)短(duan)3個月(yue)時間內(nei)就完(wan)成了方(fang)案研究、圖(tu)紙設計、規劃(hua)及(ji)綠(lv)遷手(shou)續辦(ban)(ban)理(li)、洽商進(jin)場、設備采(cai)購供貨、電力(li)(li)設備安裝調試(shi)、施(shi)工(gong)驗收、送(song)電等全(quan)部工(gong)作(zuo)。該(gai)項目位于綠(lv)化(hua)帶內(nei),地(di)理(li)位置(zhi)特殊(shu),只能在有限的范(fan)圍(wei)內(nei)進(jin)行施(shi)工(gong),且需要辦(ban)(ban)理(li)綠(lv)遷、占(zhan)掘(jue)路,施(shi)工(gong)過程困難大,手(shou)續程序繁多,但為了保證(zheng)按(an)時完(wan)成送(song)電,八號(hao)線(xian)(xian)公司提(ti)前謀(mou)劃(hua)、精(jing)心組織、嚴格管理(li),在青島市各相關部門、地(di)鐵(tie)集團、供電公司的大力(li)(li)支持(chi)與幫助下,最終(zhong)高質(zhi)量(liang)高標準的提(ti)前完(wan)成了各項工(gong)作(zuo)并(bing)順(shun)利完(wan)成送(song)電任務。
青島(dao)地(di)(di)鐵8號(hao)線分線箱新(xin)建工(gong)程順利(li)送電(dian)是8號(hao)線建設(she)過(guo)程中的(de)一個重大節點。展現了(le)地(di)(di)鐵建設(she)者攻堅克(ke)難的(de)精(jing)神,不僅為1號(hao)線供(gong)電(dian)提供(gong)了(le)保障,同(tong)時(shi)也為地(di)(di)鐵8號(hao)線后續供(gong)電(dian)接入奠定了(le)堅實的(de)基礎,為建設(she)開放、現代、活力、時(shi)尚的(de)青島(dao)再添“新(xin)動能”。
